Optimizing Your Projects with Resource Leveling in Primavera P6

Effective project management hinges on efficient resource allocation. Overallocated resources can derail schedules, inflate costs, and hinder team performance. In this guide, we’ll explore how to leverage resource leveling in Primavera P6 to optimize your project schedules, prevent overallocation, and enhance efficiency.

What Is Resource Leveling?

Resource leveling adjusts activity start and finish dates based on resource availability, ensuring a balanced allocation without breaking schedule logic.

Key Benefits of Resource Leveling:

  • Preventing resource bottlenecks.
  • Maintaining logical relationships between activities.
  • Ensuring adherence to project constraints and deadlines.

What Resource Leveling Does Not Do

While leveling can make your schedule more realistic, it does not:

  • Permanently alter your schedule. You can revert changes by rescheduling.
  • Guarantee optimal results without review. Misapplied constraints can create inflexible schedules or invalid critical paths.

Step-by-Step Guide to Resource Leveling in Primavera P6

1. Set Up Priorities

Priorities determine which activities or projects the leveling tool adjusts first. Primavera P6 allows you to configure priorities at two levels:

Project-Level Priorities:

1. Right-click in the Project view.
2. Select Columns > Customize > General Tab, and add Project Leveling Priority.
3. Assign lower numbers for higher priority projects.

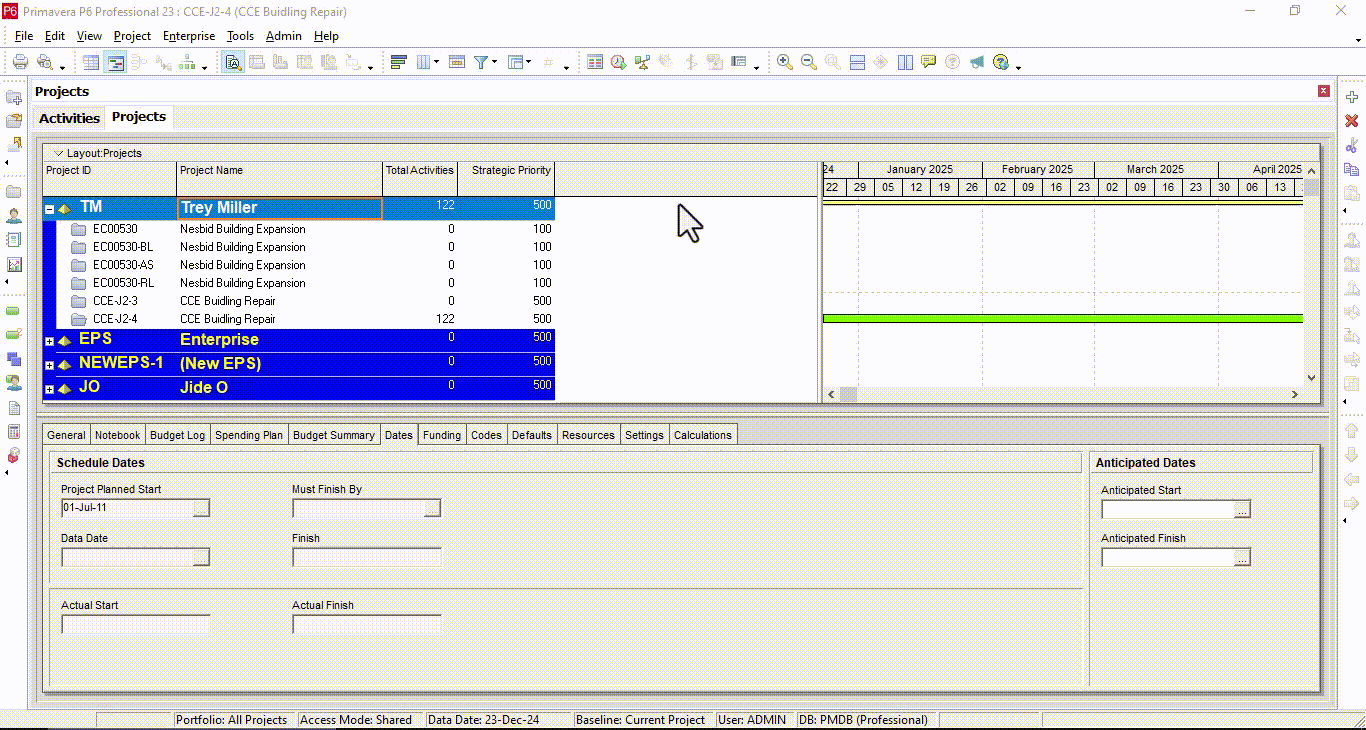

Project view

Activity-Level Priorities:

1. In the schedule view, right-click and choose Columns > General Tab.
2. Add Activity Leveling Priority.
3. Choose from preset levels (e.g., low, normal, high) or define custom priorities.

Activity-Level Priorities

2. Identify Overallocated Resources

Review your resource assignments for overallocation:

• Navigate to the Activities Window > Resource Usage Profile.
• Look for red bars in the graph, indicating overallocated resources.
• Filter the view to focus on specific resources or projects.

3. Open the Resource Leveling Tool

  • Go to Tools > Level Resources, or press Shift + F9.

4. Configure Leveling Options

In the Level Resources dialog box, fine-tune options to fit your project goals:

  • Consider Assignments in Other Projects Evaluate resource demands across multiple projects by setting priority thresholds.
    Preserve Scheduled Early and Late Dates Maintains the original schedule where possible, ensuring changes stay within float.
  • Level Resources Only Within Activity Total Float Prevents activities from extending beyond their float, safeguarding project finish dates.
  • Recalculate Assignment Costs After Leveling Updates costs if leveling shifts activity dates into different cost periods.
  • Log to File Generates a detailed log of all changes made during leveling for easy review.

Tip: If no leveling priorities are set, Primavera defaults to Activity ID, which may not reflect your project’s strategic goals.

5. Execute the Leveling

Click Level to begin the process. Primavera P6 will automatically adjust activity dates based on the parameters you’ve set.

Execute the Leveling

6. Review and Adjust

After leveling, assess the updated schedule:

  • Analyze the Resource Usage Profile: Ensure all overallocations are resolved.
  • Review the Critical Path: Confirm it remains valid and achievable.
  • Check the Leveling Log: Identify moved activities and unresolved issues.

If the results are unsatisfactory, you can:

  • Adjust priorities or constraints and repeat the leveling process.
  • Reschedule the project to revert changes and start fresh.

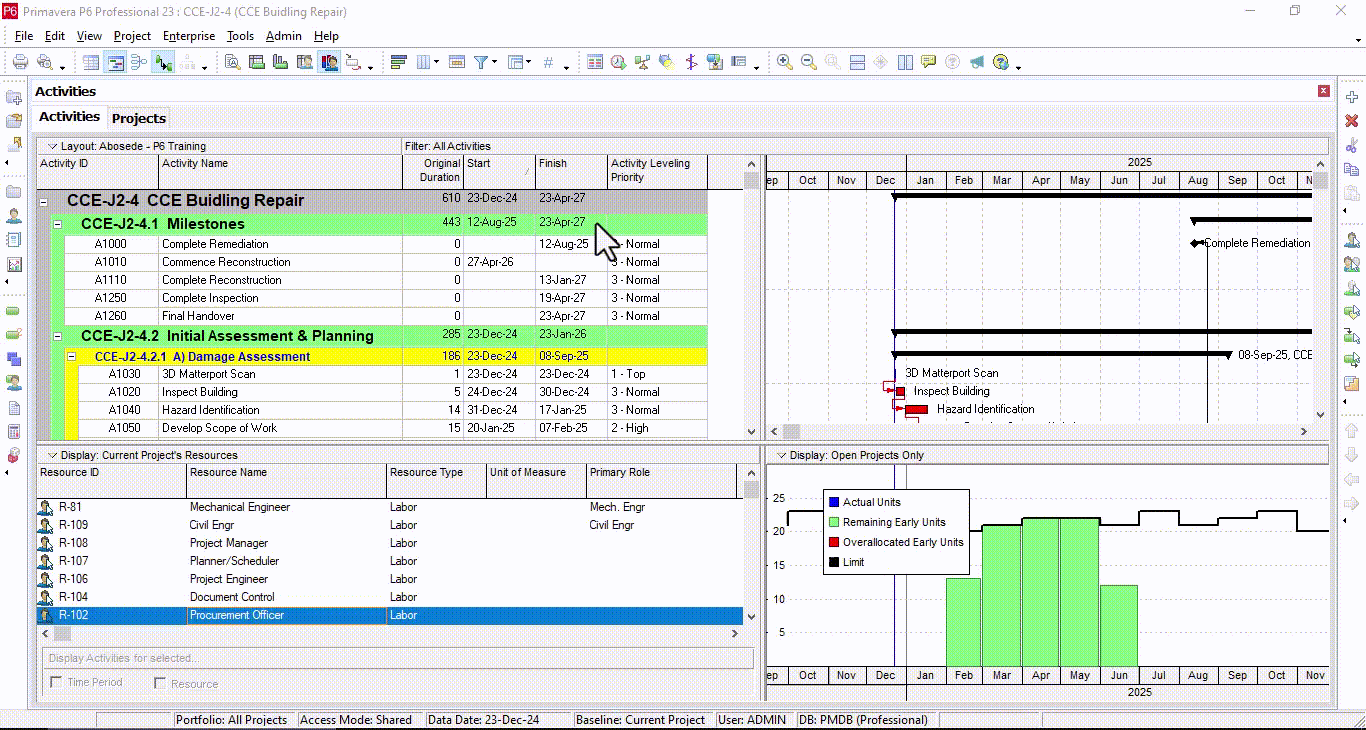

Adjust

Recent Posts

Transitioning from Primavera P6 to Oracle Primavera Cloud: Resource Analysis

June 17, 2025

Transitioning from P6 to Oracle Primavera Cloud:Resource Analysis Resource Analysis: Primavera P6 vs. Primavera Cloud…

Read More

Training

June 16, 2025

Global Project Management Course Offerings Global PM offers comprehensive, hands-on training for project management professionals,…

Read More

Transitioning from Primavera P6 to Oracle Primavera Cloud: Mastering Resource Management

June 5, 2025

Transitioning from P6 to Oracle Primavera Cloud: Mastering Resource Management Switching from Primavera P6 to…

Read More

Agile Project Management in Construction? A Modern Approach to Building Smarter

June 3, 2025

In an industry known for tight deadlines, complex stakeholder relationships, and ever-changing site conditions, Agile…

Read More

Primavera P6 to Oracle Primavera Cloud: The EPS vs. Workspaces

May 20, 2025

Primavera P6 to Oracle Primavera Cloud: The EPS vs. Workspaces Author: Kari Jackson, PMP, PMI-ACP…

Read More
